|

				|

						| Project Log:  Saturday, September 6, 2014
 Reassembling spars and rigging is one of those jobs that
						can seem to stretch on interminably, all the more so
						when one has weeks away from the project to exacerbate
						what was already a lengthy process.  I began mast
						reassembly back in April 2014, though I'd hardly worked
						often or consistently since then.

 Though there was no immediate need for the masts, it was
						time to finish up the assembly and rigging work and
						knock this off the list and clear my conscience as well
						as my tool cart.  Though a few unknowns remained
						with placement of halyard winches and cleats (which I'd
						do later), I hoped to otherwise finish the reassembly on
						both masts and be done with them for the most part.
						I'd completed the hardware and wiring work on the
						mainmast, but had just started the mizzen when I left
						off last time.

 First, though, I had one small chore on the mainmast.
						During my trial sail fitting some time earlier, I'd
						noted how the sail slide installation slot--now the only
						one accessible for the sail thanks to the new permanent
						gooseneck--was too small for the long cars required at
						the track end of the full battens.

 |
						| Photo from April 25,
						2014
  |
						| Using the longer lower opening as a guide, I marked an
						extension on the upper slot, then cut off the lower
						section with a Dremel tool.  Some people seem
						enamored of Dremel tools; I am not one of them, but in
						this instance it did the trick where nothing else could.
						This doubled the length of the original slot and would
						provide ample room for the sail slides.  Later I
						installed the slide stop in that threaded hole nearby.
 |
						|
    |

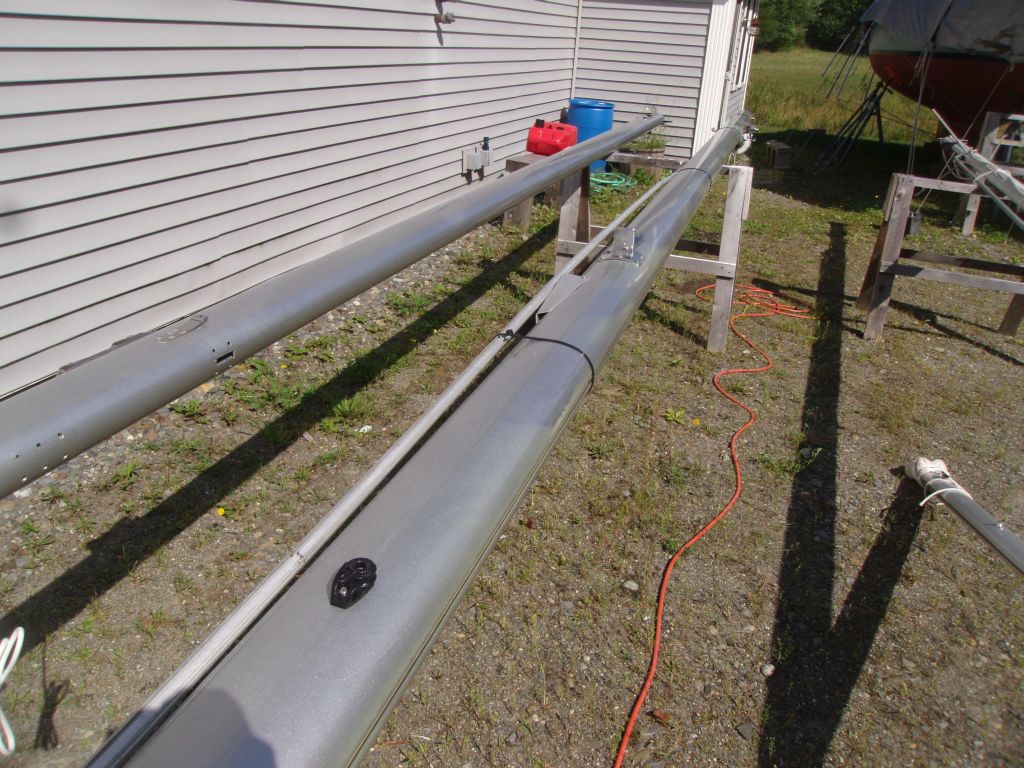

						| Planning ahead for lazy jacks, I installed a pair of
						small cheek blocks on the spar, about 48" above the
						spreaders.  I'd worry about the rest of the system
						another time.
 |
						|


  |
						| Next door on the mizzen mast, I reinstalled the sheaves
						at the top of the mast.  I liked the installation
						system for the sheaves on both spars, which featured a
						simple stud held in place with external cover plates,
						making for easy removal or installation.
 |
						|


  |
						| There wasn't much hardware on the mizzen:  for now,
						about all I could install was the tang for the triatic
						stay (which ran from the top of the mainmast, through a
						sheave at the top of the mizzen, and down to
						pilothouse-height for ease of connection and adjustment)
						and the nearby tang for the mainsheet connection.
						Because these pieces had originally been riveted in
						place, in order to reuse the same locations and holes I
						had to increase the size of the fasteners to 5/16",
						larger than I would have liked but OK enough in the end.
						For this and other hardware, I followed my usual
						protocol of tapped holes in the spar, with Tef-Gel on
						the fasteners.  I'd figure out the mizzen halyard
						winch and cleat (and whatever else might be needed)
						later.
 |
						|
  |
						| Next, I installed the radome mount, which I'd recycled
						from the original setup, though I'd painted it some time
						earlier.  I installed this with 1/4" machine screws
						at each of the four mounting locations.  I
						temporarily installed the mount itself, but removed it
						for more convenient storage till later.  It just
						bolted in place with four bolts through the mast bases.
						I had an adapter plate to allow me to fit the Simrad
						radome to this mount (originally for
						Raymarine...actually Raytheon, which dated the mount),
						but I wasn't ready to install that yet.  (Well,
						actually I was more than ready to install it and be
						done, but it didn't make sense at this particular time,
						with a long winter's storage ahead.)
 |
						|
      |
						| Now I turned to the mizzen rigging, starting with the
						small tubular spreaders and their fixed stays, which
						acted like jumper stays in a way, as they simply
						stiffened the mast along its own column and didn't have
						attachment points on the boat.  I reinstalled the
						spreaders and their rigging now just to be done with it,
						even knowing that the projecting spreaders and stays
						would probably irritate me when it came time to store
						the mast for the winter.  So be it...fewer jobs to
						be done later.  This had all dragged on long
						enough, and I was interested to note from my rigging
						labels that it had been four years nearly to the date
						that I first removed the rigging from these spars. At
						least a year too long.

 I wrapped up mizzen work by installing the remaining
						shrouds:  a pair leading off the tang at the mast
						head.  I secured the stays along the mast with
						plastic wire ties for safekeeping.
 |
						|


  |
						| Finally, I installed the stays on the mainmast, glad to
						finally remove these from storage in my shop and have
						the spars more or less ready to step whenever I was.
						Soon, I'd wrap up the spars and move them to my storage
						area.
 |
						|
      |
						|  |
						| Total Time Today:  3.75 hours
 |
						| <
